Project Information

Main Content

PROJECT BASICS

DUE TO COVID19 COMPETITION WAS CANCELED. NEXT YEARS TEAM WILL BE ALLOWED TO USE THE SAME RULES AND BRIDGE DESIGN.

Project Location: Cal State Fullerton

pROJECT cONSTRAINTS

The project constraints are detailed in the AISC Student Steel Bridge 2020 Rules provided.This years rules detailed both footings as skewed. Also, the loading combinations and locations are different this year based on the footings.



TASKS

The following tasks are the major tasks needed to complete the scope of work.

Task 1: Research

Task 2: Analysis

Task 3: Shop Drawings

Task 4: Fabrication Management

Task 5: Final Product Improvements

Task 6: Construction Preparations

Task 7: AISC Competition

Task 8: Project Management

Task 9: Impacts

The following information is the Schedule and GANTT Chart. The GANTT Chart details 170 work days. Our critical path is 112 days. The critical path includes the time that the subcontractos, KZELL Metals and Mingus Welding Team. The critical path is crucial to being sure that the team is ready to compete on April 1, 2020. Additionally, the Expected Staffing Hours from the team is below. The table includes a detailed view of the Senior Engineer (SENG), Project Engineer (ENG), Engineer in Training (EIT), Lab Technican (LAB) and the Administative Assistant (AA). The team is expected to spend 1118 hours on this project. Each team member will operate as each of the positions provided.

GANTT CHART 2019

  GANTT CHART 2020

EXPECTED STAFFING HOURS

FINAL STAFFING HOURS



Total Proposed Cost

The total proposed cost is detailed in the table below. This will make up the teams personnel costs, subcontracting, materials and competition logistics. Also, see the billiable rates for each position below.

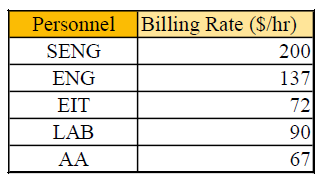

BILLABLE HOURS



FINAL TOTAL COST
